Can Expandable Container Houses Be Relocated Without Damage?

Ⅰ.Why Are Expandable Container Houses Suitable For Relocation?



Expandable container houses are manufactured with transportation and installation in mind. Before transportation, the expandable sections can be folded into a more compact configuration, reducing the overall footprint compared with the fully expanded building.

Foldable Structure

The folding design allows the house to switch between two basic states:

Expanded → Folded → Transported → Reinstalled → Expanded

This makes the building suitable for projects where the accommodation location may change over time.

For example, a contractor may use an expandable house as temporary staff accommodation during one project and relocate the units to another construction site after the project is completed.

Steel Structural Frame

The main frame provides the structural foundation of the house and is designed to support the building during normal use and transportation when handled according to the manufacturer's requirements.

The frame, hinges, lifting points, and expansion mechanisms should all be considered part of the relocation process.

Compact Transportation Dimensions

When folded, an expandable container house occupies considerably less space than when fully expanded. This makes road transportation and container shipping more practical.

However, the exact transportation method depends on the model, folded dimensions, total weight, local road conditions, and applicable transport regulations.

news-2200-1236



Ⅱ.What Needs To Be Done Before Relocation?



The condition of the house before relocation can have a major effect on the safety of the move. The building should be prepared according to its specific design rather than simply being lifted and transported.

Remove Or Secure Interior Items

Furniture, appliances, loose equipment, and other movable items should normally be removed or properly secured before transportation.

Items such as:

  • Cabinets
  • Beds
  • Tables
  • Appliances
  • Decorative objects
  • Loose electrical equipment

can move during transportation and potentially damage the interior.

Disconnect Utilities

Electricity, water, drainage, gas, internet, and other external connections need to be disconnected before the house is moved.

Any pipes, cables, or connections attached to the surrounding site should be separated carefully so that they do not remain connected when lifting begins.

Fold The House Correctly

Expandable sections should be folded according to the manufacturer's operating procedure.

The folding sequence is important because different models may use different hinges, locking systems, support components, and expansion mechanisms.

The house should be completely secured in its transportation configuration before loading.

Inspect The Structure

Before lifting, the structural frame, hinges, locking points, lifting points, doors, windows, and other critical components should be checked.

If damage or deformation is found before relocation, it should be repaired before transportation rather than discovered during the move.

news-2720-3168

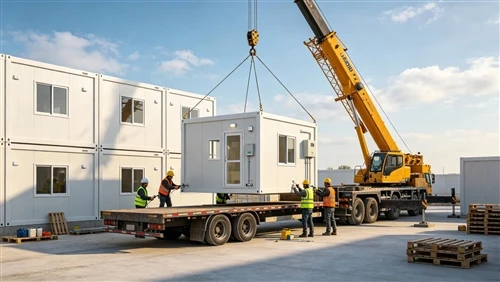

Ⅲ.How Can The House Be Transported Safely?



Once the house has been prepared, the next step is choosing an appropriate transportation and lifting method.

Lifting Equipment

Depending on the model and site conditions, cranes, forklifts, trailers, or other suitable equipment may be used.

The lifting method should follow the manufacturer's instructions and use the designated lifting or support points where applicable.

Improper lifting can place excessive stress on the frame or cause localized deformation.

Secure The House During Transportation

After loading, the folded house should be secured to the transportation platform.

  • The transport plan should account for:
  • Total weight
  • Center of gravity
  • Loading position
  • Tie-down points
  • Road conditions
  • Vehicle capacity
  • Overall transport dimensions
  • Local transportation regulations

The transportation company should also be informed of the actual dimensions and weight of the unit before arranging the vehicle.

Protect Vulnerable Components

Doors, windows, exterior panels, roof components, and other exposed parts should be protected against impact during loading and transportation.

If the house contains glass panels or finished interior components, additional protective packaging may be appropriate.

Avoid Unplanned Structural Modification

Relocation should not require cutting or modifying the primary structural frame unless specifically approved by the manufacturer and qualified professionals.

Structural modifications made without engineering review can affect both the building's performance and its ability to be safely transported again.

news-2000-1124



Ⅳ.What Should Be Checked After Relocation?



Relocation does not end when the house reaches its new destination. A second inspection should be completed before the unit is put back into service.

Prepare The New Site

The new location should have:

  • A suitable foundation or support system
  • A level installation surface
  • Adequate drainage
  • Sufficient expansion space
  • Suitable truck and equipment access
  • Prepared electrical and plumbing connections

For expandable houses, the available space should be based on the fully expanded dimensions, not just the folded transportation size.

Inspect Before Expansion

Before unfolding the house, inspect the frame, hinges, panels, doors, windows, and locking components for any visible damage that may have occurred during transportation.

If anything appears abnormal, the expansion process should be stopped until the issue has been evaluated.

Test The Main Functions

After installation, the house should be checked again.

Depending on the configuration, this may include:

Folding and expansion mechanisms

Doors and windows

Electrical systems

Water supply

Drainage

Lighting

Air conditioning

Interior fixtures

Exterior sealing

Professional Handling Matters

An expandable container house can potentially be relocated more than once, but its condition after each move depends on how it is handled.

Repeated relocation, improper lifting, overloading, road impacts, unauthorized modifications, or inadequate site preparation can increase the risk of damage.

For this reason, relocation should be treated as a planned engineering and logistics operation rather than simply moving a conventional container.
